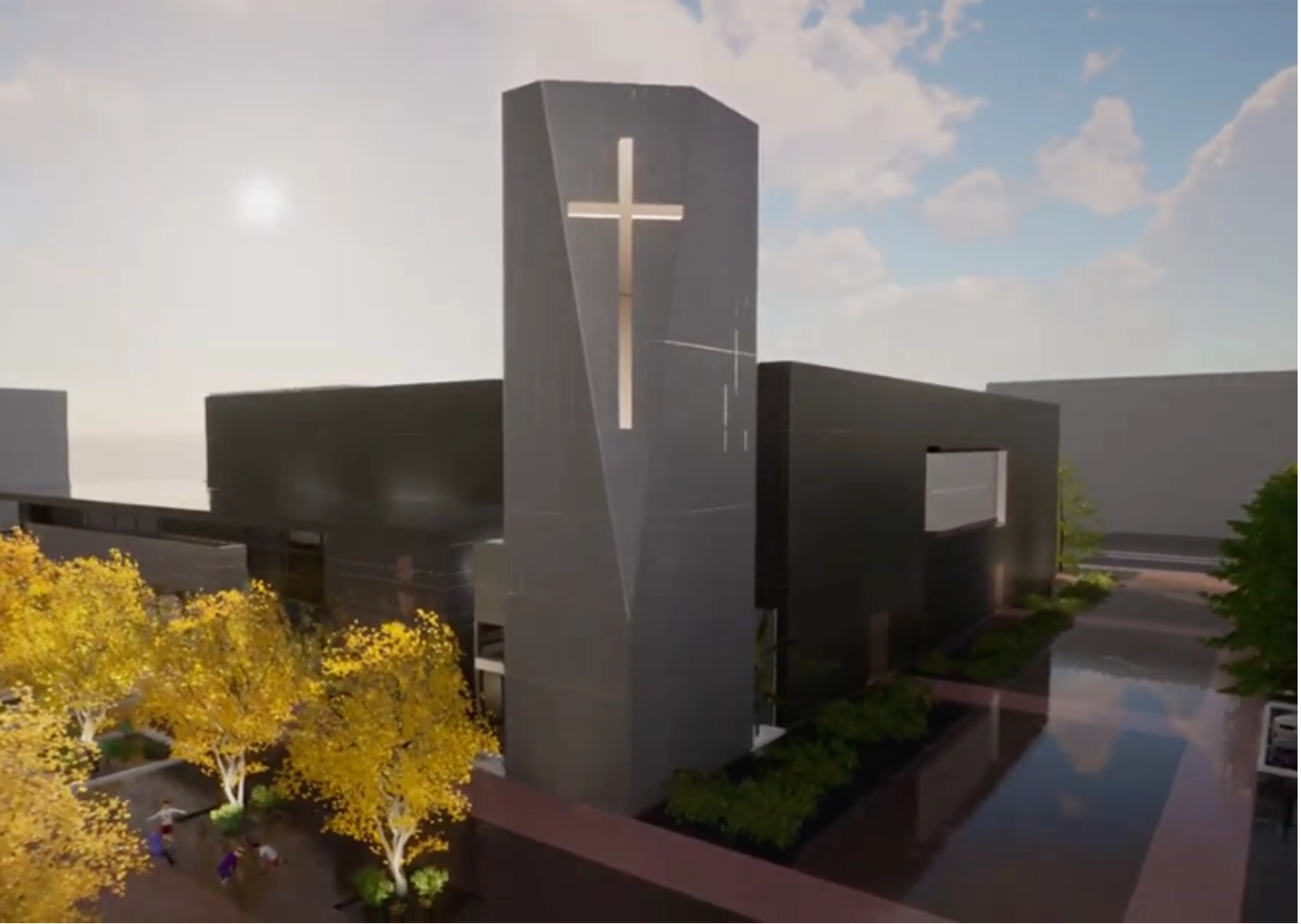

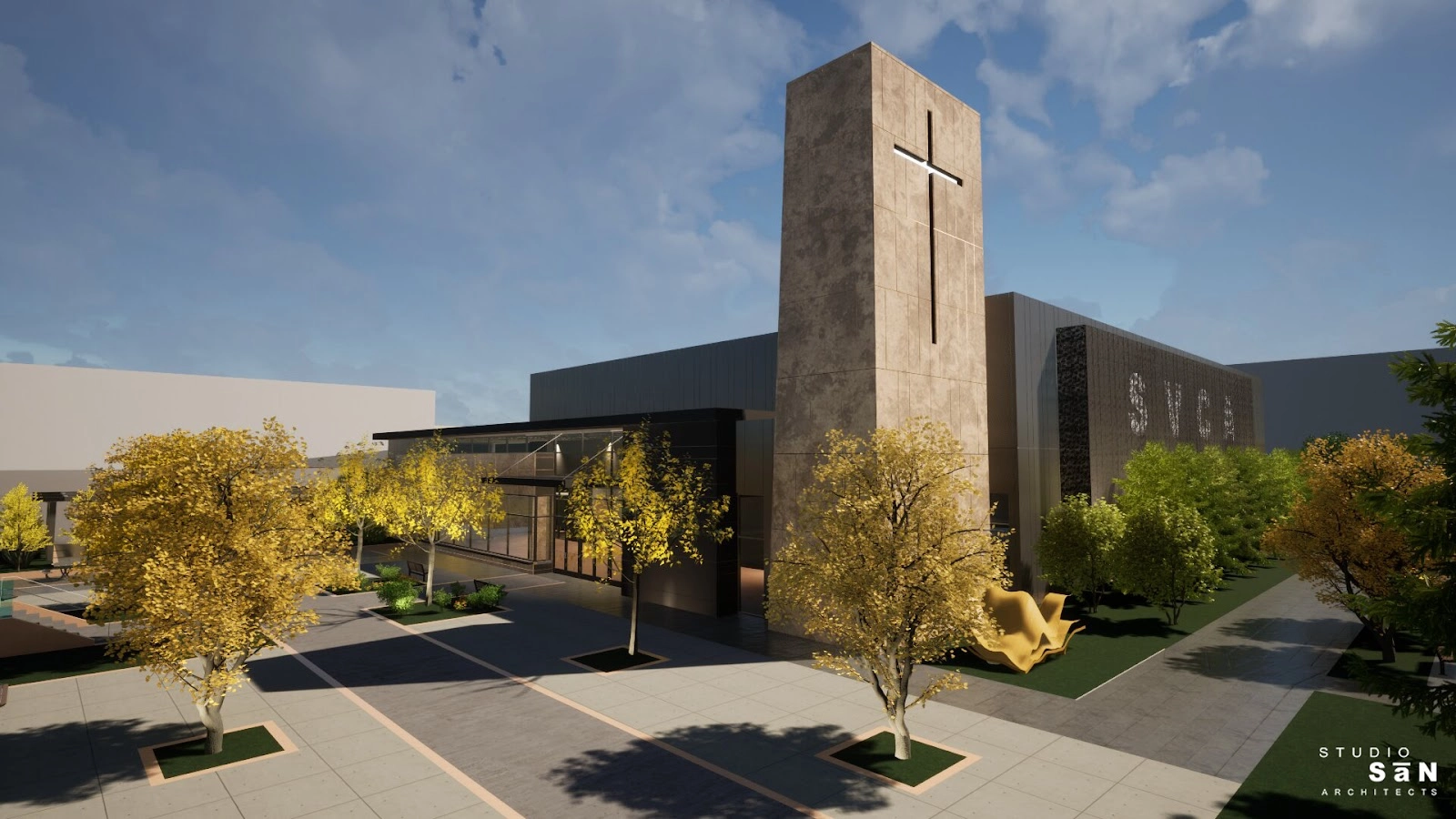

Since the city provided review comments in February, the architect and project team have actively cooperated in modifying the design plan and supplementing required materials, while entering the design development phase, which will be completed soon. The project team has also conducted further discussions and revisions on restrooms, baptismal pool, and stage TV wall. After design development is completed, the building design will enter the final construction drawing phase, while the church prepares to clear the site for demolition of the current Bethel Hall location in early September. We expect to receive the critical Building Permit from the city in August and look forward to the official groundbreaking in September.
Official start of new building construction
Demolition of current site
Expected approval of construction permit
Construction drawings completed, submitted permit application to city
Current site cleared and moved
Construction drawings 70% complete, awaiting geotechnical report to complete foundation design
Contractor 2nd construction cost estimate completed, exceeding initial budget by 22%
Construction drawing phase begins
Father's Day special offering
City completed design project review approval (Although design review passed, fire department, public works, and building construction departments required additional materials, causing a 3-month delay)
Design development phase completed
Mother's Day dinner fundraiser
City preliminary review completed and requested additional materials
Design development phase begins
Confirmed with architect and builder to reduce construction costs to meet church budget
Design schematic phase completed, submitted to city for review
Design schematic initial draft completed
City approved demolition and reconstruction
Selected project team
Established building committee
